Weekly Progress Updates 12.9.22
- agertz
- Dec 9, 2022
- 1 min read

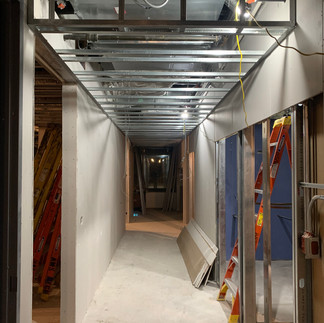

Thank you again for your continued patience and cooperation through our renovation. I encourage you to check our project website updatesatthe643.com for more information including virtual tours, high performance and technology being used on the project. New progress photos are attached and you can also use HoloBuilder to see updates of the progress work.
This Week
Completed fireproofing of steel on the second floor
Tile backer drywall in the restrooms
Continuing to frame soffits and ceilings on the second floor
Continuing drywall taping
Continuing overhead MEP rough-in on the first floor
In-wall pantry plumbing testing and insulating
Prepping the first-floor steel for framing and spray insulation
Saturday
The office will be closed this Saturday, 12/10, for waterproofing work.
Next Week
Below are some activities taking place next week as we continue to stay on schedule.
Drywall taping will continue
Framing soffits and ceiling on the second floor will continue
Last concrete pour on the first floor
Start and finish spray proofing on the first floor
Start cold-form metal framing of the exterior wall
Start ceramic tile prep on the second-floor restrooms
General reminders
During construction, parking spaces have been assigned. Please ensure that you use only your spot or park offsite.
Visitors will not be able to park in the lot and visiting employees should be prepared to find remote parking. Double parking will not be permitted.
Emergency issues related to the 643 renovations should be routed to Jack Brown at 847-338-4308.
All general building maintenance/engineering issues should still be sent to Tom Brannon at 847-609-7893.
